How to Lift, Move and Store Precast Concrete Barriers Without Damage: Premium Handling Guide for UAE Contractors (2026)

A single chipped corner on a precast concrete barrier may appear minor. In the UAE regulatory environment, it can result in RTA rejection, repainting costs and client dissatisfaction. Across our Jebel Ali facility, we observe that more than 80 percent of barrier damage occurs not during manufacturing, but during lifting, transport and storage on site.

At Arab Precast, we engineer every barrier for structural performance and for safe handling under repetitive lifting conditions. This guide outlines the definitive methodology for lifting, moving and storing precast concrete barriers without compromising integrity, safety or compliance.

Executive Summary: The Cost of Improper Handling

Improper handling of precast concrete barriers in UAE projects leads to three measurable consequences.

First, financial loss. A 3 meter Jersey barrier costing AED 350 to 650 requires AED 80 to 150 for cosmetic repair and AED 25 to 50 for repainting of RTA compliant markings. Corner damage requiring structural assessment may result in complete rejection.

Second, programme delay. RTA and DMT inspectors in Dubai and Abu Dhabi routinely reject barriers with visible cracks, spalling or damaged reflective tape, necessitating replacement and re inspection.

Third, safety risk. A 3 meter barrier weighing 1500 to 2400 kg, if lifted incorrectly, presents a severe hazard to personnel and equipment. OSHA 1926.251 and UAE Municipality safety codes mandate certified lifting methods and trained operators.

This guide provides verified methods, equipment capacity calculations and storage protocols to eliminate these risks.

Search Intent Analysis: Why Contractors Search Handling Methods

Google search analysis for the UAE indicates that queries related to barrier handling reflect primarily informational and commercial investigation intent.

Informational intent: Site engineers and safety officers seek to understand correct lifting points, equipment requirements, centre of gravity and stacking limitations to prevent damage and ensure compliance with safety regulations.

Commercial investigation intent: Procurement and plant managers compare lifting equipment options such as barrier clamps versus forklift slots, evaluate forklift and Hiab capacity against barrier weight, and assess total cost of handling including crane mobilisation and storage space.

Transactional intent: Following evaluation, users search for suppliers whose products include certified lifting anchors, documented weight and handling guides, and buyback programmes for undamaged units.

This article addresses all three intents with engineering data, comparative tables and field proven protocols specific to UAE conditions.

Understanding Barrier Weight and Centre of Gravity

Accurate knowledge of weight is fundamental to safe lifting. Precast concrete barriers in UAE are manufactured to standard dimensions with predictable mass.

Barrier TypeLengthHeightBase WidthApproximate WeightCentre of Gravity
Single Side Small2 m600 mm500 mm500 to 600 kgCentral, low
Single Side Standard3 m800 mm600 mm900 to 1200 kgCentral, low
Jersey Standard3 m1000 mm600 mm1500 to 1800 kgCentral, 400 mm from base
F Type Standard3 m1067 mm600 mm1800 to 2400 kgCentral, 450 mm from base
Interlocking Heavy Duty3 m1200 mm750 mm2400 to 3000 kgCentral, 500 mm from base

The centre of gravity is located centrally along length and low within the profile, providing inherent stability when lifted vertically. Any lifting method that introduces side loading, dragging or point pressure on corners will compromise this stability and cause chipping.

Full specifications including concrete grade C40 to C50 and reinforcement details are available on our precast concrete barriers product page and precast concrete products range.

Comprehensive definitions of types and manufacturing standards are provided in what are precast concrete barriers complete guide.

Lifting Methods: Comparative Analysis for UAE Sites

Method 1: Automatic Barrier Clamp or Grab — Recommended

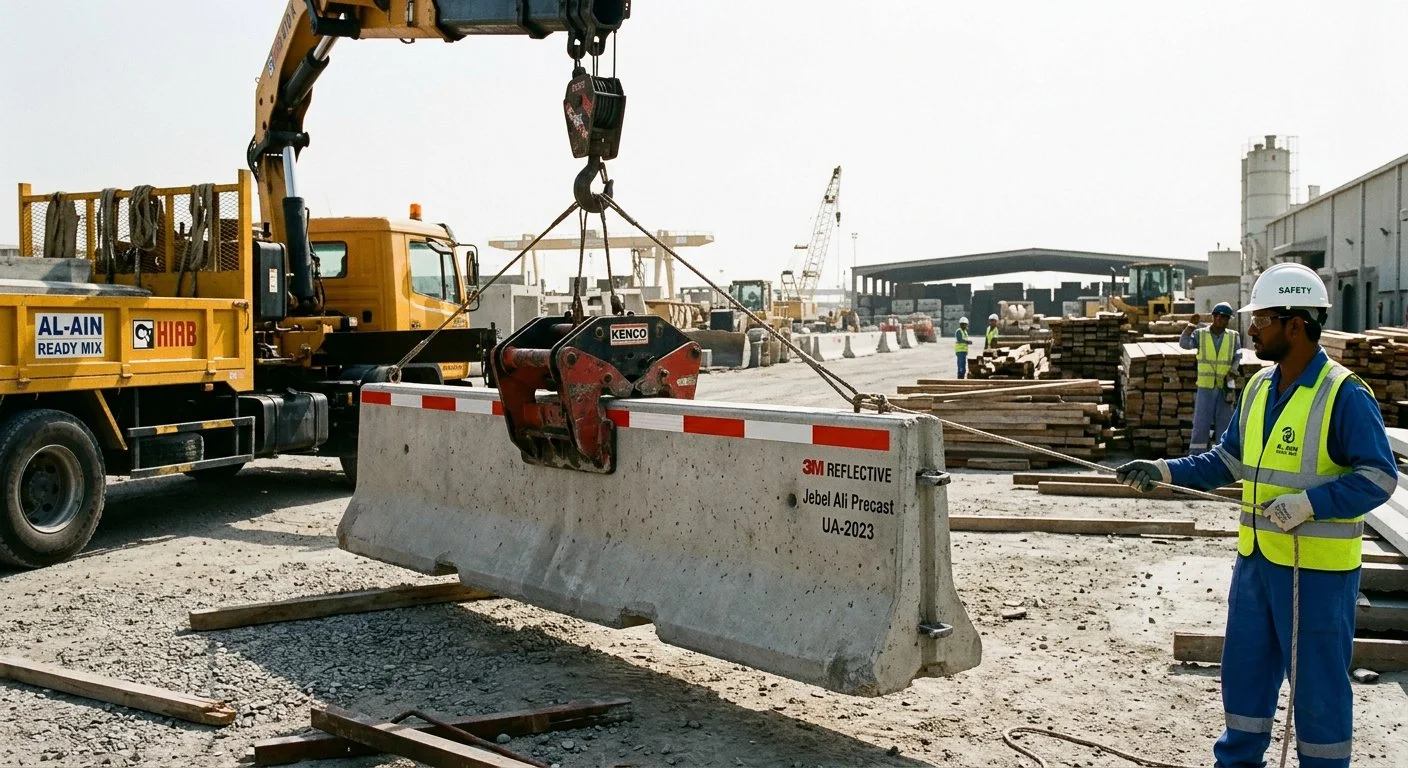

The automatic barrier clamp, commonly known as Kenco Barrier Lift KL12000, is the premium method for repetitive lifting in UAE infrastructure projects.

Operation sequence: Position clamp above centre of barrier, lower fully to collapse unit onto barrier top, raise. The mechanical scissor action grips automatically via elastomer pads that adjust to slope of Jersey or F Type profile. No auxiliary hydraulics required. Once barrier is placed firmly on ground, tension release opens clamp automatically.

Advantages: Full surface contact prevents corner chipping, no manual slinging required, operator remains in cab, lifting time reduced from 4 minutes with chains to 90 seconds, and pads are replaceable for painted barriers.

Capacity: KL12000 model provides 12,000 lbs capacity with 6 to 12 inch grip range, suitable for barriers up to 6 meters. For heavy duty interlocking units, KL30000 provides 30,000 lbs capacity.

This method is mandated by many Tier 1 contractors in Dubai South and Abu Dhabi Midfield projects for its safety and speed.

Method 2: Forklift Slots — Conditional Use

Many UAE standard barriers include cast in forklift slots or drainage scuppers at base, originally designed for drainage, adapted for handling.

When to use: Only when barrier has intact, purpose designed forklift pockets, no visible cracks around slots, and forklift capacity exceeds barrier weight at extended load centre.

Protocol: Inspect slots for damage, align forklift parallel to barrier, centre forks with slots, adjust fork spacing to 24 to 36 inches, insert forks fully through barrier to maximise stability, lift 6 to 12 inches to test stability, then transport with load low and slow.

Limitations: Slots are primarily drainage features, not certified lifting points. Repeated forklift lifting causes micro cracking around slot edges, especially with misaligned forks. Not recommended for F Type above 2 meters length without barrier clamp.

Method 3: Embedded Lifting Anchors with Chains — Factory Standard

Arab Precast barriers include 2 numbers DEHA pin anchors or spherical head anchors cast into top face, rated for 2.5 to 5 tons with factor of safety of 5.0 for repetitive lifting as per WorkSafe NZ and OSHA guidelines for concrete barriers, service lids and counterweights.

Protocol: Use certified chains or straps rated above barrier weight, ensure chains hang at maximum 30 degrees from vertical, connect to fork mounted lifting hook, never lay chains over forks, never stand under load, lift vertically without side loading.

This method provides certified lifting points and is suitable for all barrier types when clamp is unavailable.

Method 4: Chains or Slings Wrapped Around Barrier — Not Recommended

Wrapping chains or nylon slings around barrier profile creates point pressure on corners and edges, causing chipping and surface damage. Slings also reduce forklift capacity and introduce swing risk. This method should be avoided for finished barriers requiring RTA approval and reflective tape preservation.

Comparative Table: Lifting Methods for UAE Contractors

Lifting MethodSuitable Barrier TypesEquipment RequiredRisk of DamageSpeed per BarrierRTA Acceptance for Finished Barriers
Automatic Barrier Clamp KL12000All Jersey, F Type, Single Side up to 6 mHiab or crane with hookVery low, elastomer pads protect surface90 secondsPreferred, preserves tape and corners
Forklift SlotsBarriers with intact slots, up to 3 mForklift 5 ton capacity minimumModerate, slot edge cracking possible2 minutesConditional, inspect slots before use
Embedded DEHA Anchors with ChainsAll types with certified anchorsCrane or Hiab with lifting hook, certified chainsLow when vertical3 to 4 minutesAccepted, factory standard
Chains or Slings Wrapped AroundNone for finished barriersForklift or craneHigh, corner chipping and tape damage4 to 5 minutesNot recommended, causes rejection

Guidance on selecting barrier type by application and handling requirements is available in our how to choose the right precast barrier for your UAE project decision guide.

Equipment Selection Matrix: Matching Weight to Machine Capacity

Selecting inadequate equipment is a primary cause of tipping and barrier damage.

Barrier WeightMinimum Forklift Capacity at 600 mm Load CentreMinimum Hiab CapacityRecommended Lifting AttachmentTransport per 6 m Truck
500 to 600 kg 2 m single side3 ton forklift5 ton meterForklift slots or DEHA anchor12 to 14 units
900 to 1200 kg 3 m single side5 ton forklift8 ton meterBarrier clamp or DEHA anchor8 to 10 units
1500 to 1800 kg 3 m Jersey standard7 ton forklift or 10 ton Hiab12 ton meterBarrier clamp KL12000 mandatory6 to 7 units
1800 to 2400 kg 3 m F Type10 ton forklift or 12 ton Hiab15 ton meterBarrier clamp KL12000 mandatory5 to 6 units
2400 to 3000 kg 3 m heavy dutyNot recommended with forklift20 ton meter craneBarrier clamp KL300004 to 5 units

Note: Forklift capacity reduces significantly with extended load centre. A 3 meter barrier at 1500 mm from mast reduces rated capacity by 30 to 40 percent. Always check data plate and consult manufacturer load chart.

Transport planning including truck counts and delivery emirates is detailed in our how many concrete barriers do you need takeoff guide and pricing analysis in precast concrete barrier prices UAE complete guide.

Safe Transport Procedures for UAE Roads

Transport damage often exceeds lifting damage due to inadequate securing.

  • Load barriers in upright position, supported at bearing areas, never on side.
  • Separate units with timber dunnage 100 mm thick to prevent concrete to concrete contact and allow fork access.
  • Secure with ratchet straps over dunnage, not directly over concrete corners.
  • Protect reflective tape with cardboard or foam during transit, especially for RTA projects on Sheikh Zayed Road and E311.
  • Maximum stack of two barriers high during transport, as per Manitoba Infrastructure Specification 1082, to avoid twisting and cracking.
  • Verify actual weight before transport. A 3 meter F Type at 2400 kg times 6 units equals 14.4 tons plus truck weight, exceeding many 6 meter truck limits. Use low bed for heavy duty units.

Upon arrival, inspect each barrier for cracks, spalling or tape damage before offloading. Document with photos for RTA record.

Storage and Stacking Best Practices for UAE Yards

Proper storage in Dubai Industrial City, JAFZA and Mussafah yards prevents long term deterioration.

Storage FactorRecommended PracticeRationale
Ground conditionHard, level, compacted surface, lean concrete or asphaltPrevents tilting and differential settlement
DunnageTimber 100 x 100 mm, two per barrier, aligned vertically between layersPrevents twisting and allows lifting access
Stack heightMaximum 2 barriers high for 3 meter units, maximum 3 high for 2 meter unitsExceeding causes bottom unit cracking and instability
Separation600 mm aisle between stacks for inspection and liftingSafety and FIFO access
Protection from trafficBollards or concrete barriers around storage zonePrevents forklift collision
UV and weatherNo additional cover required for concrete, cover reflective tape if stored more than 30 daysPreserves tape adhesion in 50 degree heat
FIFO managementLabel each stack with date, type and batch IDEnsures first in first out usage and QA traceability

Storing barriers close to final installation location minimises multiple handling. Each handling cycle increases damage probability by approximately 5 percent. WorkSafe NZ guidelines recommend lifting into final position directly from delivery trailer where possible, rather than intermediate storage.

For projects involving multiple precast elements, coordinated storage of barriers, precast pole foundations for DEWA approval and precast trench covers with load ratings on shared dunnage optimises yard space and crane utilisation.

Common Handling Mistakes and Financial Impact in UAE

MistakeConsequenceCost Impact AEDPrevention
Dragging barrier across groundBottom abrasion, base uneven, RTA rejection80 to 150 repair plus re transportAlways lift, never drag
Using undersized forkliftTipping, barrier drop, personnel injury2000 to 5000 plus injury liabilityVerify capacity at extended load centre
Wrapping chains around cornersCorner chipping, tape damage, aesthetic failure25 to 50 repaint plus 80 repairUse barrier clamp or DEHA anchors
Stacking 3 high on soft groundBottom barrier cracking, stack collapse350 to 650 replacement per unitHard level surface, max 2 high for 3 m
Forcing forks into damaged slotsSlot cracking, fork wedging, extraction delay2 hours labour plus repairInspect slots, use clamp if damaged
No dunnage between unitsConcrete to concrete contact, surface spalling50 to 100 per unit cosmetic repairTimber dunnage 100 mm between all layers

A contractor in Al Quoz reported AED 12,000 in repair costs for 40 barriers due to chain wrapping damage before switching to barrier clamp, which eliminated damage in subsequent 300 unit handling.

Compliance with municipality requirements for lifting points and identification is detailed in municipality regulations for concrete barriers in Dubai and Abu Dhabi and broader application guidance in top uses of precast concrete barriers in UAE.

Why Arab Precast Barriers Are Engineered for Safe Handling

Arab Precast designs handling integrity as a core specification, not an afterthought.

  • Certified lifting anchors: 2 numbers DEHA anchors per unit rated 2.5 to 5 tons with factor of safety 5.0 for repetitive lifting, in accordance with precast barrier handling best practices.
  • Factory controlled strength: C40 to C50 concrete with 7 day steam curing ensures handling strength of 40 MPa before dispatch, preventing edge breakage during early lifting.
  • Precision dimensional tolerance: Plus minus 2 mm ensures uniform bearing on dunnage and prevents point loading.
  • Documented weight: Each delivery note includes exact weight per unit for equipment selection, eliminating guesswork.
  • Protective finish: Optional foam protection for reflective tape during transport for RTA projects.

Our barriers are also designed for integration with other infrastructure elements including pole foundations and trench covers, allowing single supplier logistics and single crane mobilisation.

Frequently Asked Questions

What is the safest method to lift precast concrete barriers in UAE

The automatic barrier clamp such as Kenco KL12000 is the safest and fastest method. It grips via elastomer pads, requires no manual slinging, preserves corners and reflective tape, and allows operator to remain in cab. For barriers without clamp access, use embedded DEHA anchors with certified chains at maximum 30 degrees from vertical.

Can forklift slots be used for all barrier types

No. Forklift slots are primarily drainage features adapted for handling. They are suitable only for barriers up to 3 meters with intact slots and no visible cracks. For F Type and heavy duty interlocking barriers above 1500 kg, barrier clamp is mandatory to prevent slot edge cracking.

How high can precast concrete barriers be stacked in UAE yards

Maximum 2 barriers high for 3 meter units and maximum 3 high for 2 meter units on hard level ground with timber dunnage between layers. Exceeding this height causes bottom unit cracking and instability, especially on sandy ground in Jebel Ali and Al Warsan.

How do I prevent corner chipping during handling

Use barrier clamp with elastomer pads, never wrap chains around corners, ensure dunnage between units during transport and storage, lift vertically without side loading, and protect reflective tape with cardboard. Inspect lifting equipment and barrier for damage before each lift.

What is the cost impact of improper handling

Cosmetic repair costs AED 80 to 150 per unit plus AED 25 to 50 for tape replacement. Structural cracking may result in complete rejection at AED 350 to 850 replacement cost. A single drop incident can incur AED 2,000 to 5,000 in equipment and personnel risk plus project delay.

Conclusion

In UAE infrastructure projects where timelines are aggressive and regulatory scrutiny is stringent, barrier handling integrity directly influences compliance, cost and safety.

Specifying barriers with certified lifting anchors, documented weight and factory applied reflective tape, combined with trained operators and appropriate equipment such as barrier clamps, eliminates the majority of damage and rejection incidents.

Arab Precast recommends incorporating handling requirements into method statements and ITPs, including equipment capacity verification, dunnage provision and FIFO storage management.

To receive a project specific handling plan including equipment recommendation, truck count and stacking layout, please contact our technical team via our contact page or WhatsApp +971 58 660 9400. You may also review our complete portfolio on the Arab Precast homepage and technical resources on our blog.
